The Calculator’s Number Was Never a Build Plan

SEPTEMBER 6, 2026 · LEADS 2 BUILD
A build schedule mounted on a site trailer beside a half-framed 40x60 post-frame shop, a pocket calculator face down on the t

A pole barn cost calculator hands a project manager exactly one thing: a sell price for a box that nobody has scheduled, crewed or changed yet. The number reaches you second-hand — the customer quoted it on the phone, the rep wrote it on the card — and from that moment the job is measured against a figure that never contained a crew day, a checkpoint or a change order.

Myth 1: The calculator's number is the job's budget

It is a price, not a budget. A calculator multiplies width, length and eave height by an average price per square foot. The budget a superintendent can run a job against is four separate figures: materials at your own yard's prices, the labour days the building needs, the services attached to it (slab, doors, insulation, site prep) and the markup on all three. A materials-only figure under-states a post-frame job by roughly a third, and a per-square-foot figure hides which third is missing.

The pain is inheriting "he said it would be about eighty-five" and having every dollar over it read as your overrun. In the 3D building designer the materials figure and the customer total sit as two separate lines, with labour worked out from the building rather than declared. That split is the only budget you can defend on site, because it is split the way the money actually leaves.

Cost breakdown
Item
Base
Markup
Total
Materials
Framing
$18,420.00
%$10
+$1,842.00
$20,262.00
Sheathing
$12,905.50
%$0
$12,905.50
Trim
$3,180.00
%$0
$3,180.00
Doors & Windows
$9,640.00
%$500
+$500.00
$10,140.00
Foundation
$4,275.00
%$0
$4,275.00
Fasteners
$1,388.25
%$0
$1,388.25
Materials
$49,808.75
LaborOnOff
Erect shell
2,400 sf · 176 hrs × $42.25/hr
$7,436.00
%$0
$7,436.00
Walk doors & windows
3 × 1.5 hrs
$190.13
%$0
$190.13
Overhead doors
2 × 4 hrs
$338.00
%$0
$338.00
Lean-to / porch
480 sf · 22.4 hrs
$946.40
%$0
$946.40
Labor
$8,910.53
Services & add-onsSave as templateUse template+ Add service
Concrete & Site Package2 lines · $20,250.00Remove these lines
Concrete Pad
40′ × 60′ = 2,400 sq ft × $7.25 = $17,400
×
$17,400.00
%$0
$17,400.00
Site Prep & Grading
1 × $2,850 = $2,850
×
$2,850.00
%$0
$2,850.00
Seamless Gutters
168 lin ft × $9.50 = $1,596
×
$1,596.00
%$0
$1,596.00
Custom Garage Door
2 × 9′ × 8′ @ $1,850 = $3,700
×
$3,700.00
%$0
$3,700.00
Services
$25,546.00
Whole job
Marks up materials + labor + services together
$84,265.28
%$8
+$6,741.22
$91,006.50
Customer total
$84,265.28
+$9,083.22
$93,348.50
The running figure is materials at sell price. Labour, services and markup are added underneath to reach the customer total — three lines a calculator folds into one. Real screen · sample data.

Myth 2: Square footage tells you how many crew days

Two 40x60 shops have the same square footage. One has 10-foot walls, a single slider and no lean-to. The other has 14-foot walls, three overhead doors, wainscot and a 12-foot lean-to down one side. The second is longer posts, more girts, more panel runs, three headers and a porch roof that has to tie into the main roof. That difference is days, not square feet, and days are what your crew is measured against.

When the crew hears "it's a four-day shell" from someone who priced it per square foot, the four days are a wish. The Build Schedule writes the days the labour was figured for on the job itself, and under day rates with shared surplus the pool is set by those figured days, not by how long the job takes. The crew is then racing a number that came off the parts of the building — a number you can explain when they ask where it came from.

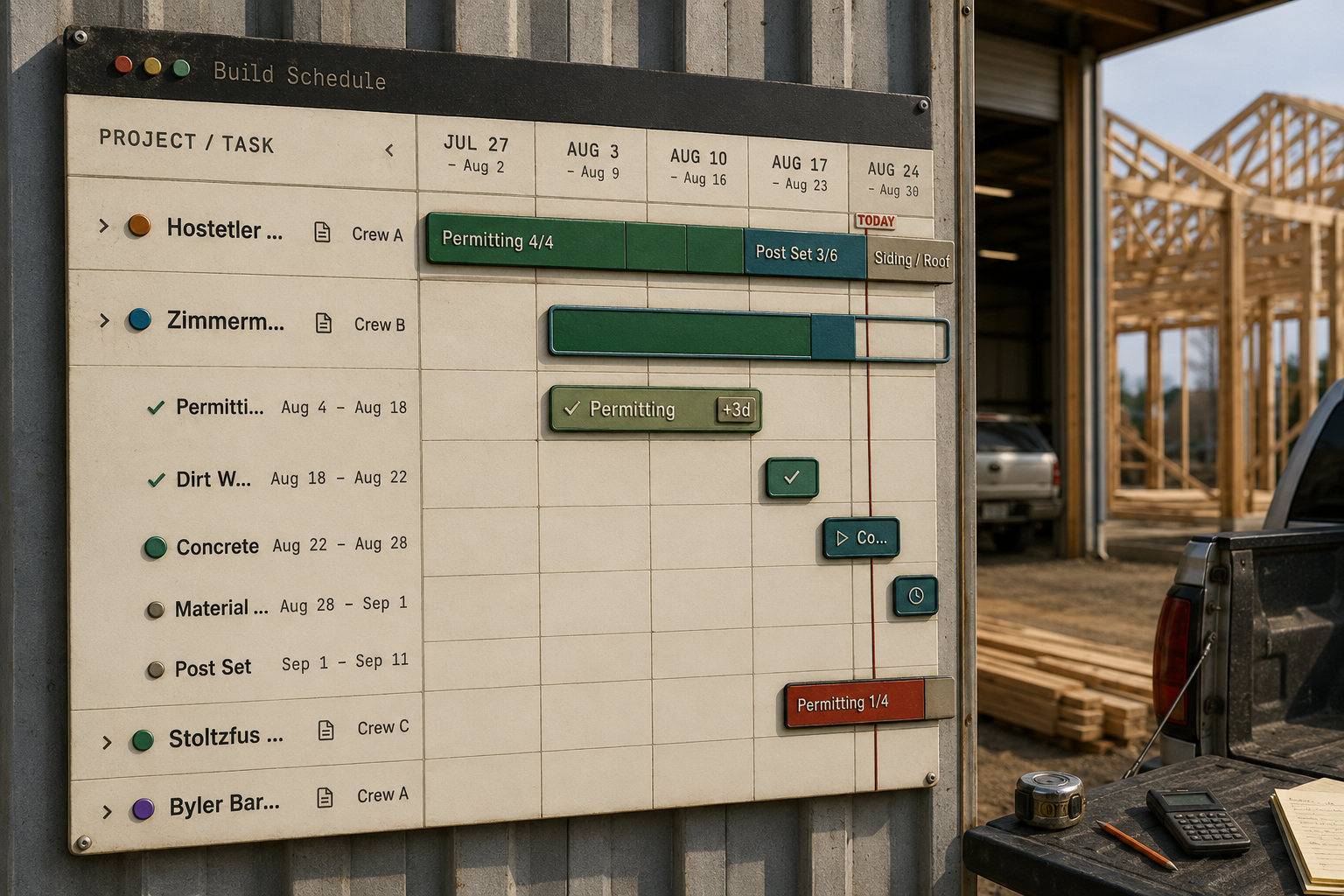

Build Schedule
Project / Task
Hostetler Equipment ShedCrew A
Zimmerman Horse BarnCrew B
PermittingAug 4Aug 18
Dirt WorkAug 18Aug 22
ConcreteAug 22Aug 28
Material DeliveryAug 28Sep 1
Post SetSep 1Sep 11
Stoltzfus ShopCrew C
Byler BarndominiumCrew A
Jul 27Aug 2
Aug 3Aug 9
Aug 10Aug 16
Aug 17Aug 23
Aug 24Aug 30
Aug 31Sep 6
Sep 7Sep 13
Sep 14Sep 20
Sep 21Sep 27
Sep 28Oct 4
Oct 5Oct 11
Oct 12Oct 18
Oct 19Oct 25
Oct 26Nov 1
TODAY
Permitting 4/4
Post Set 3/6
Siding / Roofing 0/11
46% • 38d
Permitting+3d
Concrete
Post Set0/6
Permitting 1/4
Framing 0/6
Siding / Roofing 0/11
Permitting 0/4
Slab / Foundation 0/6
Post Set 0/6
Siding / Roofing 0/11
Shutdown week — Crew B
OVERLAP
The days the labour was figured for are written on the job. The crew is measured against that figure, not against the calculator's. Real screen · sample data.

Myth 3: The number survives the first change order

A calculator's figure has no line items, so the first scope change on site has nothing to be priced against. "Add a 10x10 on the north wall" becomes a verbal extra, and a verbal extra becomes the argument at the final draw. A change order that holds carries the original contract price, the ADD or DEDUCT with its own lines, the new total and the schedule adjustment in days, and it is signed before the header goes in.

The extra door gets framed and nobody remembers agreeing to two more days. Change orders write a branded agreement per change, and the days sit on the same page as the dollars. That matters because the argument at the end of a job is rarely about the amount; it is about whether the days were ever agreed. The change order that protects your margin covers what has to be on that page.

Change order agreement
Leads2Build
Leads2Build Construction LLC

CHANGE ORDER AGREEMENT

Project Name:
40×64 Shop — Buck Hollow Road
Project Address:
1284 Buck Hollow Road, Quarryville, PA 17566
Owner/Client Name:
Marlene R. Zook
Original Contract Date:
June 11, 2026
Change Order #:
2
Date Issued:
August 24, 2026

1. Description of Change

Site condition: additional fill and compaction

Excavation exposed soft soil across the north half of the pad. Adds 96 tons of 2A modified, placed and compacted in lifts, plus a second proof-roll before forms are set.

2. Reason for Change

  • Customer Request
  • Code Required
  • Site Condition
  • Error Correction
  • Scope Addition
  • Scope Reduction
  • Other

3. Cost Adjustment

DescriptionQtyRateAmount
2A modified stone, delivered · ton96$28.50$2,736.00
Place and compact in 8" lifts · hr9$82.00$738.00
Original Contract Price:$61,420.00
ADD: $3,460.00
DEDUCT:
New Contract Total:$64,880.00
Payment Terms for This Change:
Added to the existing project payment schedule

4. Schedule Adjustment

No change to completion date
Contract time will be extended by: 4 days

5. Agreement

This Change Order modifies the original contract between the parties listed above. All other terms and conditions of the original agreement remain in full force and effect.

Work related to this change will not begin until this Change Order is signed by all parties.

6. Signatures

Owner / Client
Marlene R. Zook
Marlene R. Zook
Signed August 24, 2026
Leads2Build Construction LLC Representative
Leads2Build Construction LLC
Issued and authorized August 24, 2026
Leads2Build Construction LLC · Change Order CO-002Approved
The cost adjustment and the schedule adjustment in days on one document, on your letterhead, before the work starts. Real screen · sample data.

Myth 4: If the price was right, the schedule takes care of itself

Price and schedule are different documents, and a calculator is silent on the second one. It does not know that the concrete sub pours Saturdays, that your framing crew is on another job until the 14th, or that a five-day stage planned over a weekend is a seven-day stage. A schedule that holds is counted in each crew's working days, and it moves only when somebody records a delay with a reason and a number of days.

The pain is finding out on Friday that the crew stood down Tuesday. On the Build Schedule a blocked report from the field flags the stage delayed, attaches the reason and starts the clock, but it never moves your dates; rescheduling stays your decision, made off the record the crew created. A framer tapping a chip at seven in the morning should not be able to re-promise the customer a completion date.

Report a delay
Report a delay
Post Set · Hostetler Equipment Shed
What caused it?
WeatherCrew No-ShowMaterial IssueEquipmentPermit DelaySite AccessScope ChangeOther
Days lost
2
Hours lost
4
What happened?
Two inches of rain overnight. Post holes filled and the skid loader could not get to the back line without cutting up the yard.

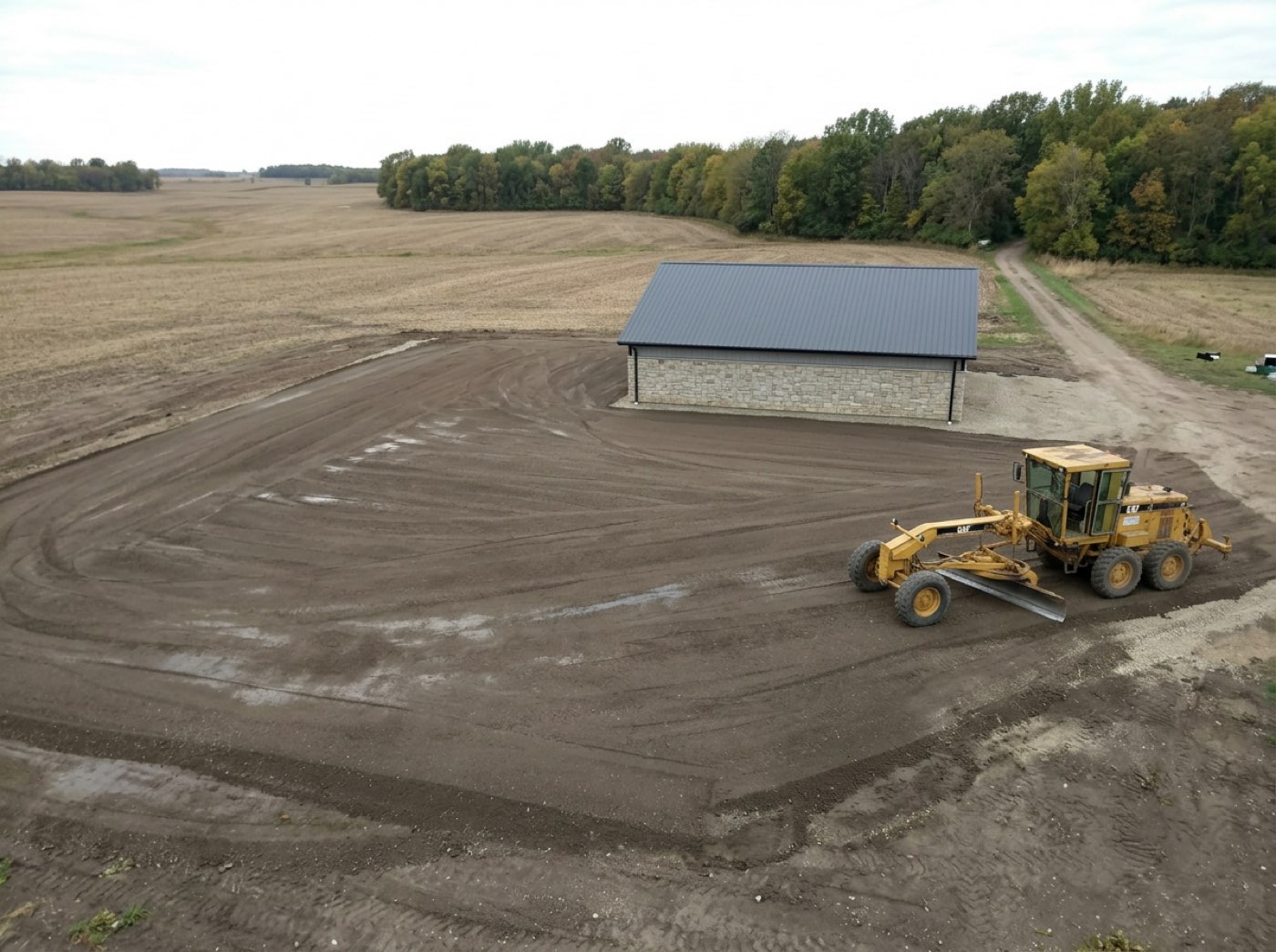

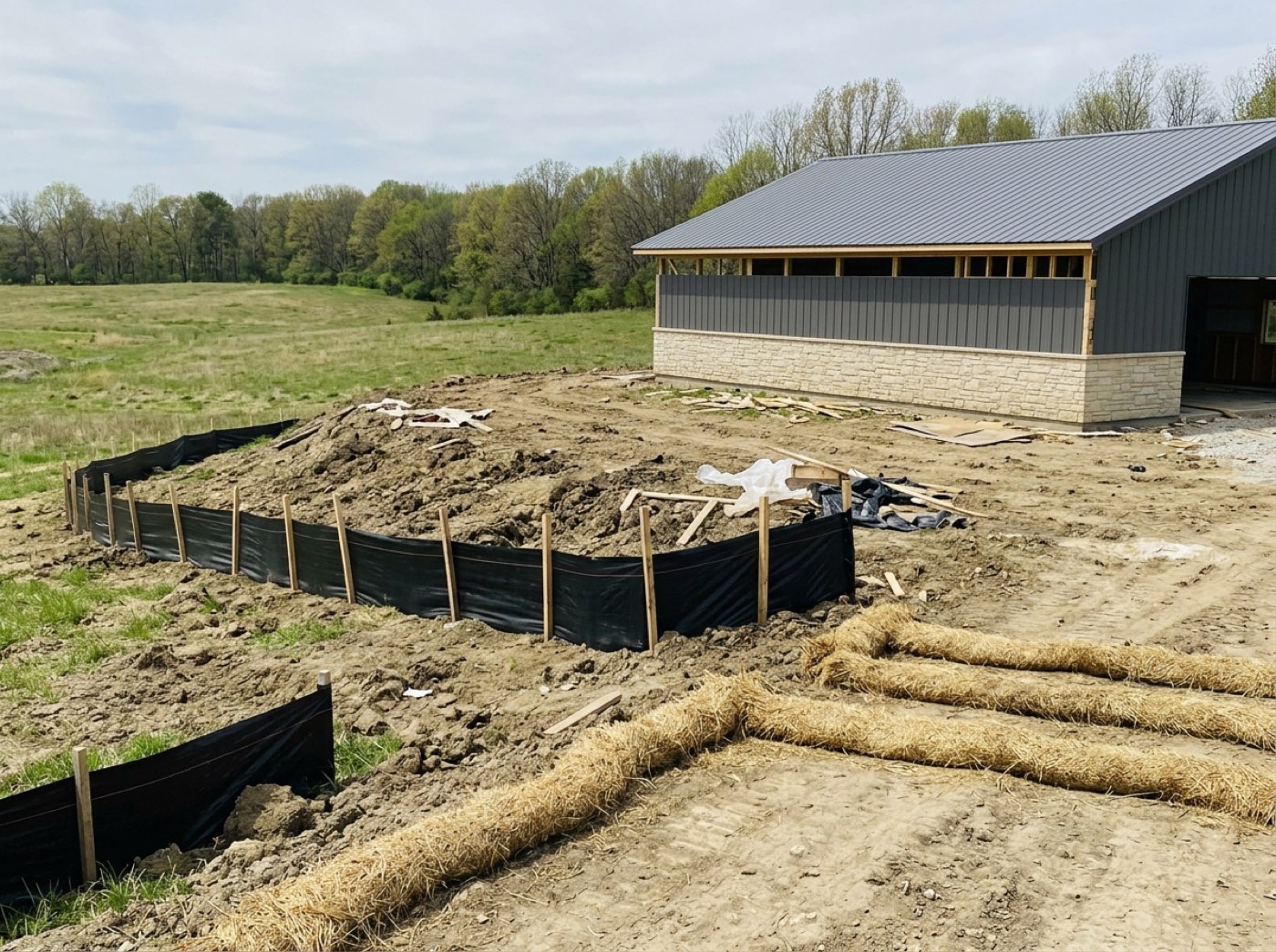

Photos (2)
Jobsite progress photoJobsite progress photo
Add photos
CancelSave delay
The stage is flagged delayed with the reason attached. The planned dates stay where they were until you move them. Real screen · sample data.

Weather is the reason you cannot argue with, which is why it needs to be recorded as a reason rather than absorbed into "it ran long". The National Weather Service forecast for the site is the record to plan the pour against; the schedule that survives contact with weather goes through how to plan for it.

Myth 5: Checkpoints and photos are paperwork; the number is what matters

The ticked checkpoints on this job are the calculator you will use next year. Every stage carries a checklist of the actual work inside it, and ticking the last box finishes the stage and stamps the real finish date. Post set that ran two days long on three barndominiums in a row is a fact about your crews, not a feeling, and it is the only thing that turns next year's guess into a figure. Stage checkpoints are where those dates come from.

A photo taken from the field carries the job, the stage, who took it and when, and it attaches to the checkpoint it proves. The shot of the posts sits beside the tick that says the posts were set. When the customer says the delay was yours, the photo of the flooded pad on the day the pour was planned is the answer, and it is already in the job file.

Myth 6: The calculator is the estimator's problem, not yours

The anchor lands on the project manager. The customer walks the site with the calculator's number in their head, and everything it never included — the fill, the engineered truss the span needed, the second overhead door — reads as you moving the goalposts. What a pole barn cost calculator can't tell a customer lists what falls outside it; your job is what happens once the customer is standing on the slab.

The fix is upstream of you and it is the reason the anchor stops mattering: the customer approves a page with their building in 3D and the price broken down, and every change order appears on their dashboard with its cost, its days and its status. That is the whole of Project Command from the customer's side. The building the price came from is the same building the schedule, the takeoff and the crew days come from, and how that geometry becomes a number is the job of the 3D building designer.

Before you take the job on

  1. Ask for the approved estimate, not the number the customer remembers.
  2. Check the figured labour days are written on the job before the crew is booked.
  3. Confirm every stage has its checklist and its crew has its own working week set.
  4. Price any scope change in writing, with days, before the work is done.
  5. Take the photo at the checkpoint, not at the end of the week.

What none of this fixes is the dirt. A site with a slope nobody walked, rock at 30 inches, or fill that was "already there" is still priced by standing on it with a shovel, and no calculator, ours included, has a line for it until someone has.

LEAD · QUOTE · SIGN · BUILD · PAID

Build the business,
not just the buildings.

One system from the first call to the final invoice — pipeline, 3D estimates your customer can see, e-sign, deposits, scheduling, change orders and a branded portal.

leads2build.com
A post-frame barndominium at dusk, warm light in every window
The great room of a finished barndominium — exposed timber trusses, a stone fireplace and a wall of windows
A finished post-frame shop with charcoal steel siding and two overhead doors
Leads2BuildBUILDER OPERATING SYSTEM
