← THE BLOG

JobNimbus, AccuLynx and What Roofing CRMs Assume About Your Job

SEPTEMBER 3, 2026 · KEITH LEMAY
JobNimbus, AccuLynx and What Roofing CRMs Assume About Your Job

Search for construction CRM software as a pole barn builder and you will land on JobNimbus and AccuLynx within about two clicks. Both are strong products with a lot of happy customers, and both were built for a trade that is not yours.

This is what they were designed around, why that design shows up everywhere once you notice it, and what to look for instead if you build post-frame.

Why roofing tools dominate the search results

Roofing is one of the largest and most competitive trades in the country, and roofing contractors buy software early. That means roofing platforms have had more customers, more revenue and more years of SEO than anything aimed at post-frame specifically.

So the search results are not telling you these are the best fit for your work. They are telling you roofing got there first.

What they are genuinely excellent at

Worth being precise, because these are good tools.

  • Insurance restoration. After a hailstorm, a roofer's job is a claim: adjuster meetings, supplements, Xactimate line items, scope disputes with a carrier. JobNimbus and AccuLynx model that workflow properly, and almost nothing else does.
  • High job volume, short cycles. A roofing company might run 200 jobs a year at five days each. Their boards, templates and automations are tuned for that throughput, and it shows.
  • Measurement integrations. Aerial roof measurement flowing straight into a proposal is genuinely slick.
  • Production boards. Moving many small jobs through crews and material orders is exactly what they do.

If you also run a roofing division, this is a real argument for using one of them. Plenty of companies do.

The assumptions underneath

Software encodes the shape of the job it was built for. Three assumptions matter here.

The customer is not paying — an insurer is. The whole flow expects a claim number, an adjuster, a scope document produced by someone else, and a supplement process. Your farmer paying for a 40x60 shop has no claim, no adjuster, and no third party writing the scope. All of that machinery is inert.

The scope is a measurement, not a design. A roof is squares, pitch, layers and penetrations, and it can be measured from an aerial photo. A post-frame building is a design decision before it is a measurement: bay spacing, wall height, truss span, door placement, whether there is a lean-to. Nobody can measure a building that does not exist yet.

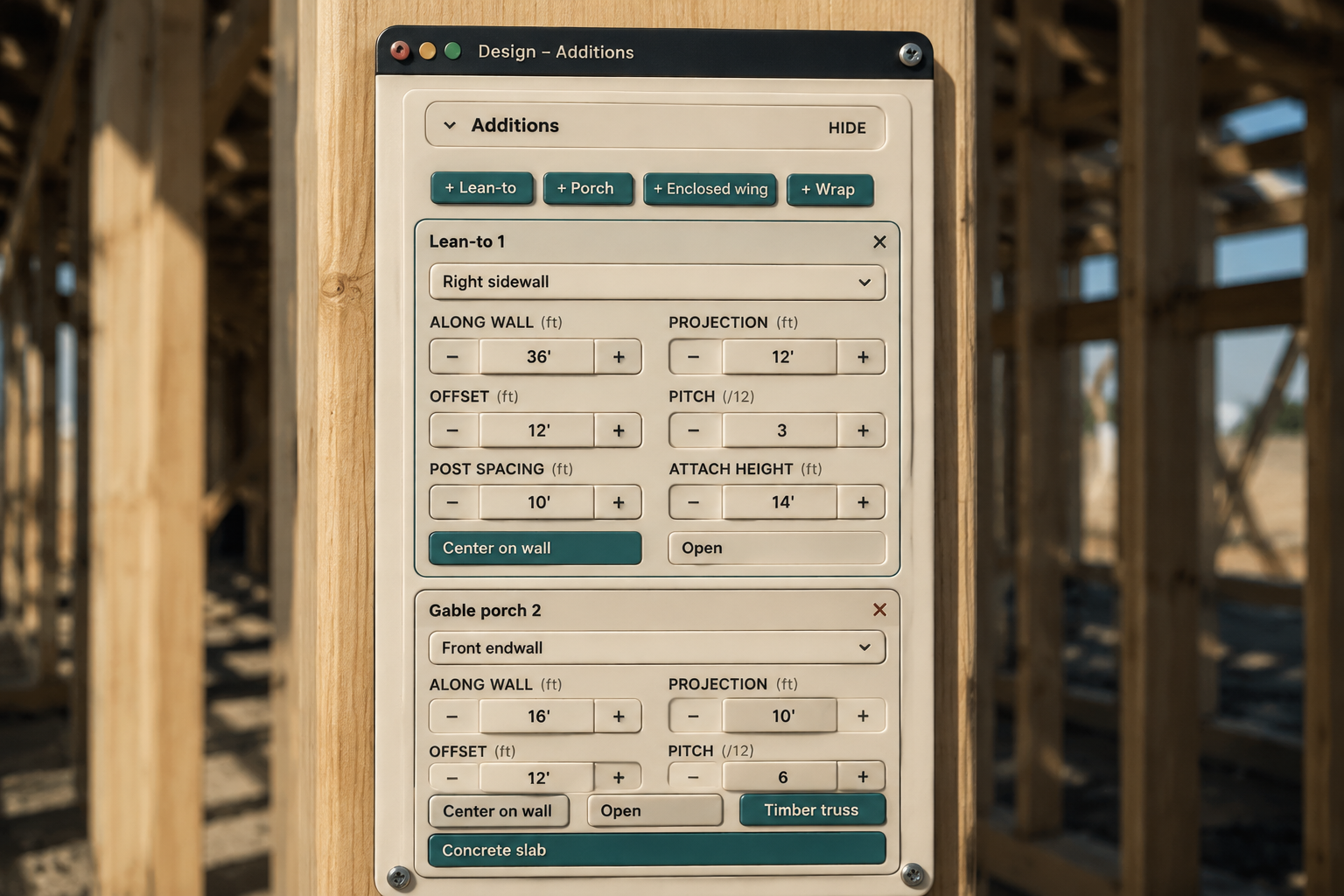

Design — Additions
AdditionsHide
+ Lean-to+ Porch+ Enclosed wing+ Wrap
Lean-to 1
Right sidewall
Along wall(ft)
36′+
Projection(ft)
12′+
Offset(ft)
12′+
Pitch(/12)
3+
Post spacing(ft)
10′+
Attach height(ft)
14′+
Center on wallOpen
Gable porch 2
Front endwall
Along wall(ft)
16′+
Projection(ft)
10′+
Offset(ft)
12′+
Pitch(/12)
6+
Center on wallOpenTimber truss
Concrete slab
A lean-to is a design change that reframes the building — not a line added to a measurement Real screen · sample data.

One visit-to-invoice cycle. Roof goes on, invoice goes out, claim settles. Post-frame runs nine weeks and gets billed in draws against milestones. The billing model is the deepest assumption in any of these tools and the hardest to work around.

Where it bites in practice

The first place most builders notice is the estimate. A roofing estimate is a rate applied to an area. A post-frame estimate is a materials list — posts at spacing, trusses at span, girts, purlins, panel runs, trim, fasteners — where the quantities come out of the geometry of the building.

Materials
Framing
6x6 solid-sawn post (UC4B treated) (20′ stock)
360.0 LF consumed · 20×20′ · 40.0 LF waste
20 pcs
6x6 jamb post (UC4B treated) (18′ stock)
108.0 LF consumed · 6×18′ · 0.0 LF waste
6 pcs
2x6 cripple (above headers) (10′ stock)
62.5 LF consumed · 9×10′ · 27.5 LF waste
9 pcs
2x6 wall girt (16′ stock)
1,404.0 LF consumed · 92×16′ · 68.0 LF waste
92 pcs
2x8 skirt board (treated) (20′ stock)
200.0 LF consumed · 10×20′ · 0.0 LF waste
10 pcs
2x6 eave strut (20′ stock)
120.0 LF consumed · 6×20′ · 0.0 LF waste
6 pcs
2x4 roof purlin (16′ stock)
1,364.0 LF consumed · 88×16′ · 44.0 LF waste
88 pcs
2x12 opening header (cut-to-stock)
48.0 LF consumed · 3×12′ + 2×8′ · 4.0 LF waste
5 pcs
2x6 window sill (8′ stock)
16.0 LF consumed · 4×8′ · 16.0 LF waste
4 pcs
Truss C40P4 (40′ span, 4/12)
spec-string per SmartBuild convention (C{span}P{pitch}); 10′ o.c. — 2 gable + 5 common · Fink (W) webs, plated both faces (ANSI/TPI 1)
7 pcs
Sheathing
Ribbed steel (exposed fastener) roof panel, 22.1′ length
2 gable face(s) @ 36.0″ coverage · 2,742 sq ft (MBCI MasterRib (36″ coverage, ¾″ ribs @ 9″))
42 panels
Roof underlayment / condensation barrier
2,742 sq ft + 10% lap
3,016 sqft
Wall steel panel, 11.0′ length
2,102 sq ft net of openings @ 3′ coverage
67 panels
Wainscot panel, 3.0′ height
573 sq ft
67 panels
Gable-end wall steel (cut to rake)
254 sq ft of gable endwall infill — not a rectangle
17 panels
Trim
Ridge cap
60.0 LF
Eave trim
124.0 LF
Rake trim
88.4 LF
Corner trim
56.0 LF
Door/window trim
119.3 LF
Inside/outside closure strip
matches every eave run of exposed-fastener steel
124.0 LF
Doors & Windows
Overhead Door 14×12
1 ea
Entry Door 3×6.667
1 ea
Window 4×3
4 ea
Fasteners
1½″ HH panel screw (color-matched)
{sf}×1.8 over 5,896 sq ft — SmartBuild sheathing-package formula
10,613 ea
H2.5A truss-to-post tie
one per truss bearing per post line — uplift path from roof to column
40 ea
Foundation
Concrete, 18″ dia × 4′ post holes
5.8 yd3
Footing pads, 18″ dia × 6″ concrete
20 ea
Uplift restraint — full-depth concrete collar (as drawn)
20 ea

Design aid, not engineering — this is a purchase-vs-consumed takeoff from the same members the model draws. Stock lengths are yard lengths (no 60′ 2x4s). Factory trusses stay factory trusses. Not a substitute for a licensed design professional, a stamped truss package, or your local building department.

The count comes out of the geometry, because that is where the count actually lives Real screen · sample data.

Get that wrong and every downstream number is wrong. It is also where the two trades diverge most: a roofer can quote accurately from a photograph, and you cannot.

The second place is what happens when the customer changes something in week four. In a claim-shaped workflow, a change is a supplement you argue with an adjuster. In yours, it is a scope change the customer has to agree to and sign, before your crew builds it.

What to look for instead

Judge any tool against your own job, not its category:

  • Can it hold a materials list derived from the building, not a rate applied to an area?
  • Can it bill in draws tied to construction milestones?
  • Can it represent stages with different crews and different definitions of done?
  • Does a change of scope produce something the customer signs?
  • Does it assume a third-party payer anywhere in the flow? If yes, that part is dead weight for you.

On pricing, the thing worth checking is not the headline number but how it scales — per user, per job, or flat — and whether the parts you actually need are in the tier you are quoted. Ask for the total at your real crew size, in writing, before you decide. That advice applies to us as much as anyone.

The National Roofing Contractors Association is a good place to understand how differently that trade is organised, which is the clearest way to see why its software looks the way it does. From our side, how to bid a construction job without guessing covers the estimate that everything else depends on, and the construction estimate template post covers where templates stop being enough.

Concretely, the shape to look for is one where the design is the input: the building drawn in 3D and the takeoff produced from it, so a lean-to is a change to the model rather than a line added to a measurement. From there the quote is a page the customer opens, with the building in it, the sale is a pipeline built for a nine-week job, and the draws come off a build schedule with checkpoints — the billing model a roofing tool has no slot for.

Before you book a demo

  • Bring your last completed job. Ask the salesperson to build that exact building in the tool.
  • Ask how it bills a 30/40/30 draw schedule. Watch whether the answer involves QuickBooks.
  • Ask what happens when the customer adds a lean-to in week four.
  • Count how many fields in the demo relate to an insurance claim.
  • Get the price at your real user count, in writing.

One honest limit: if you run post-frame and a roofing division, none of this is clean. You will end up either running two tools or accepting that one of the two trades is the poor relation in whichever you pick. We have not solved that, and anybody who tells you they have is selling.
